AIP Supplement for Malaysia

AIRAC AIP SUP

46/26

Effective Date: 29 OCT 2026

Publication Date: 17 SEP 2026

  KUALA LUMPUR INTERNATIONAL AIRPORT (WMKK)
CONSTRUCTION OF NEW HANGAR AND ASSOCIATED WORKS FOR ASIA DIGITAL ENGINEERING - WORK SCHEDULE AND MOVEMENT AREAS RESTRICTIONS

1  INTRODUCTION

1.1  Facilities for Asia Digital Engineering (ADE) are currently being constructed at the Kuala Lumpur International Airport in Sepang, Selangor. The work involves the construction of a new parking apron, a new taxiway connecting the new parking apron to the existing Compass Swing Apron and Taxiway E5, and hangarage facilities.

1.2  The following temporary changes concerning Kuala Lumpur Aerodrome (WMKK) are taking place due to the construction work from 29th October 2026 until 30th July 2027.

1.3  The working areas for the construction works are as detailed below:

  1. APRONS AND TAXIWAYS

    No.AREACHARACTER
    1Compass Swing Apron
    1. Surface: Concrete (Rigid)

    2. Strength: PCR 787 / R / C / W / U

    2Taxiway E5
    1. Width: 24 m

    2. Surface: Asphalt (Flexible)

    3. Strength: PCR 1179 / F / C / W / U

    3New Development Taxiway M3
    1. Width: 23 m

    2. Surface: Asphalt (Flexible)

    3. Strength: PCR 830 / F / B / C / X / T

  2. AERODROME OBSTACLES

    OBST ID /DesignationOBSTTypeOBSTPositionELEV / HGTMarking / Type, Color
    LC 1 – 25TLifting Crane 1024304.94N1014329.42E44 mOrange/Yellow
    LC 2 – 25TLifting Crane 2024305.43N
    1014326.97E
    44 mOrange/Yellow
    LC 3 – 25TLifting Crane 3024304.47N1014051.98E44 mOrange/Yellow
    LC 4 – 25TLifting Crane 4024303.95N1014325.99E44 mOrange/Yellow
    LC 5 – 25TLifting Crane 5024301.78N1014327.50E44 mOrange/Yellow
    LC 6 – 25TLifting Crane 6024301.61N1014324.35E44 mOrange/Yellow
    LC 7 – 150TLifting Crane 7024302.37N1014325.53E51 mOrange/Yellow
    LC 8 – 150TLifting Crane 8024303.83N1014327.54E51 mOrange/Yellow
    LC 9 – 500TLifting Crane 9024300.58N1014326.04E60 mOrange/Yellow
    LC 10 – 500TLifting Crane 10024303.12N1014324.37E60 mOrange/Yellow

1.4  Local Traffic Regulations

1.4.1  Aircraft movement will not be permitted in closed portions of the Compass Swing Apron and Taxiway E5.

1.4.2  The routes to be used by aircraft when taxiing, entering or exiting from the Compass Swing Apron and Taxiway E5 will be specified by Air Traffic Control. The issuance by Air Traffic Control of a taxi route to an aircraft does not relieve the pilot-in-command of the responsibility to maintain separation with other aircraft in the movement area or to comply with Air Traffic Control directions intended to regulate aircraft movement.

1.4.3  During the construction period, pilots are advised to be cautious of open excavations, workers, construction materials, and equipment, especially when taxiing on the Compass Swing Apron and Taxiway E5, near cordoned or barricaded areas where work is on-going.

1.4.4  When IAPP is activated, all other work activities, personnel, vehicles, and equipment shall maintain a minimum distance of 100 metres from the designated activity area. This 100-metre exclusion zone shall remain in effect throughout the operation and shall only be lifted once the IAPP has been fully stand down.

2  CONSTRUCTION WORKING HOURS

2.1  The construction work will be carried out 24 hours within the hoarded-up areas on the landside.

2.2  The construction works on the connecting taxiway and airside service road will be carried out in stages to minimize operational disruptions.

2.3  The construction works on the connecting taxiway and painting of secondary markings on the Compass Swing Apron will be carried out during runway closure hours.

3  CHARTS

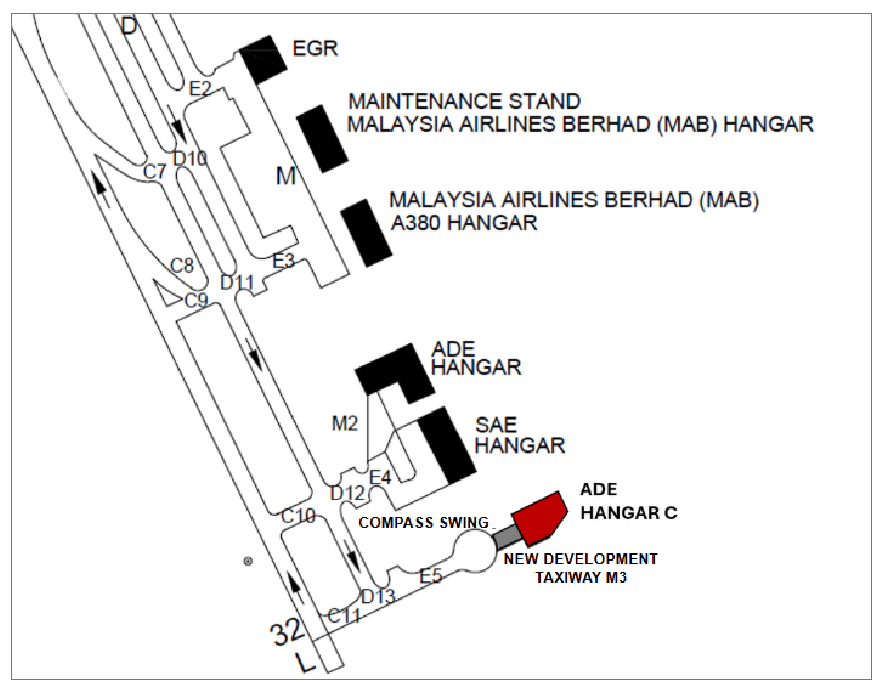

3.1  Refer to charts below for more information:


4  CONTACT

4.1  For any information and queries to contact:

Name:Wan Mohamad Ezzat Farhan Bin Wan Mohamad Nasir
Designation:Senior Executive, ADE Project team
Email:ezzat@airasia.com

5  VALIDITY

5.1  This AIRAC AIP Supplement will remain in force until 30th July 2027. Any updates, changes, or cancellation to this supplement will be notified through NOTAM.
